Slope stabilisation at Furama Riverfront Hotel

Explore the engineering challenge, site works and practical solutions from Hocklim’s project portfolio.

Completed GeoBarrier terraces at York Hill
Completed GeoBarrier terraces at York Hill

The Challenge

Heavy monsoon rainfall triggered a landslip on the slope between Outram Secondary School and Furama Riverfront Hotel, near Jalan Minyak and York Hill. The affected section had lost its vegetation cover.

Figure 1: Landslip near Jalan Minyak and York Hill

The Solution

Hocklim proposed the GeoBarrier System to repair and stabilise the slope. The 22-metre slope presented a drainage challenge: a single terrace would not manage the concentrated subsurface water efficiently.

The existing slope had a gradient of 32°, compared with 70° for the GeoBarrier face. A single-terrace arrangement would have required substantial backfill, increased costs and created a poor fit with the surrounding slope, particularly at its crest.

Design of multi terrace GeoBarrier System

Hocklim developed a customised arrangement with multiple terraces. A ground lock system reduced the need for geogrid lengths of approximately 15.4 metres and helped protect the system against erosion during heavy rainfall.

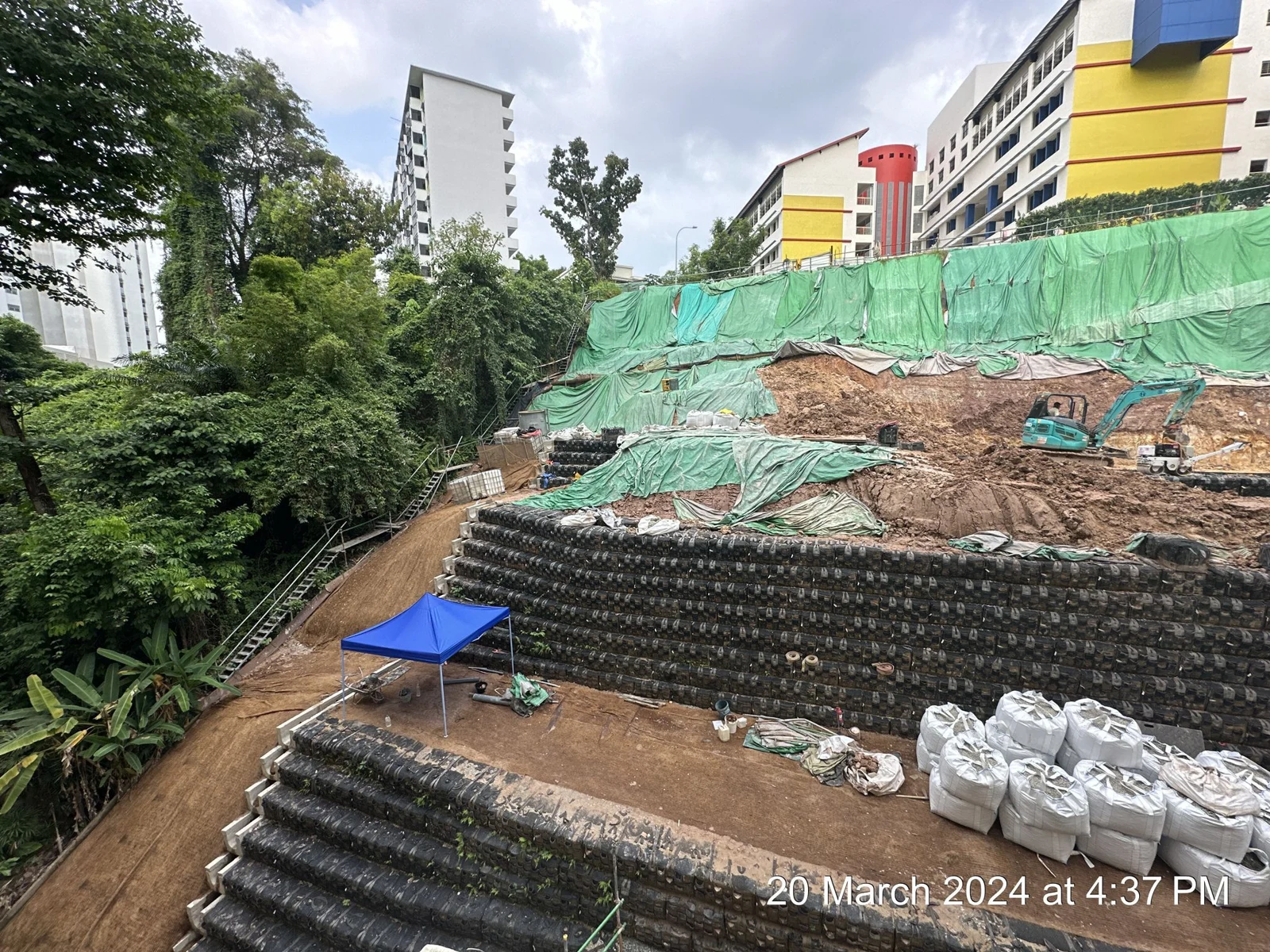

Figure 2: Layers of GeoBags installed in the multi terrace GeoBarrier system.

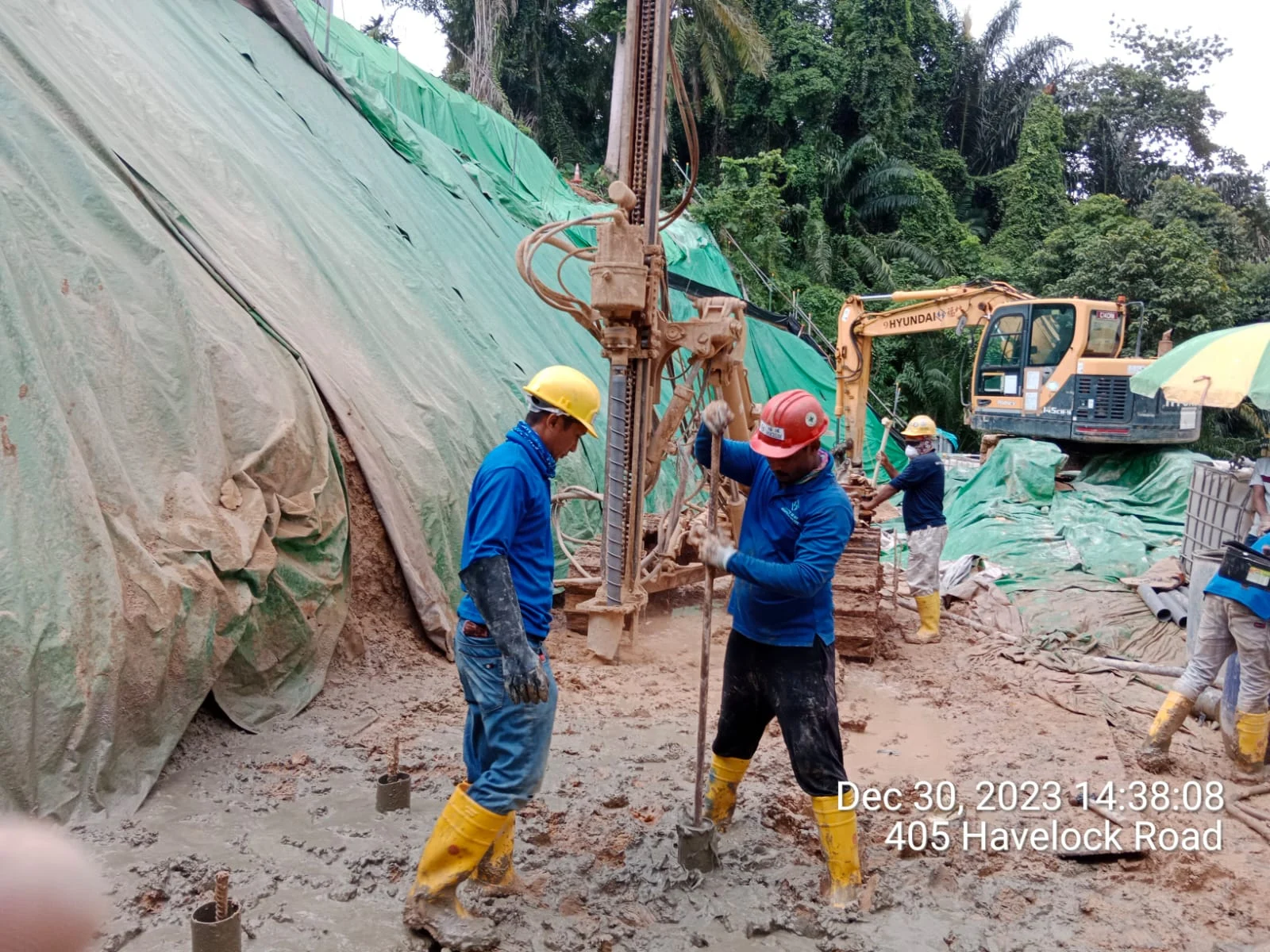

Figure 3: Installation of the ground lock system

Features of multi terrace GeoBarrier System

The York Hill design comprises five terraces. Each has surface runoff and subsurface drains at its toe, helping remove excess water and limit accumulation within the slope.

Each terrace also provides a berm that serves as a working platform for construction, material storage and machinery access.

The stepped arrangement reduces the difference between the existing slope contour and the GeoBarrier face, helping the completed works fit the surrounding terrain.

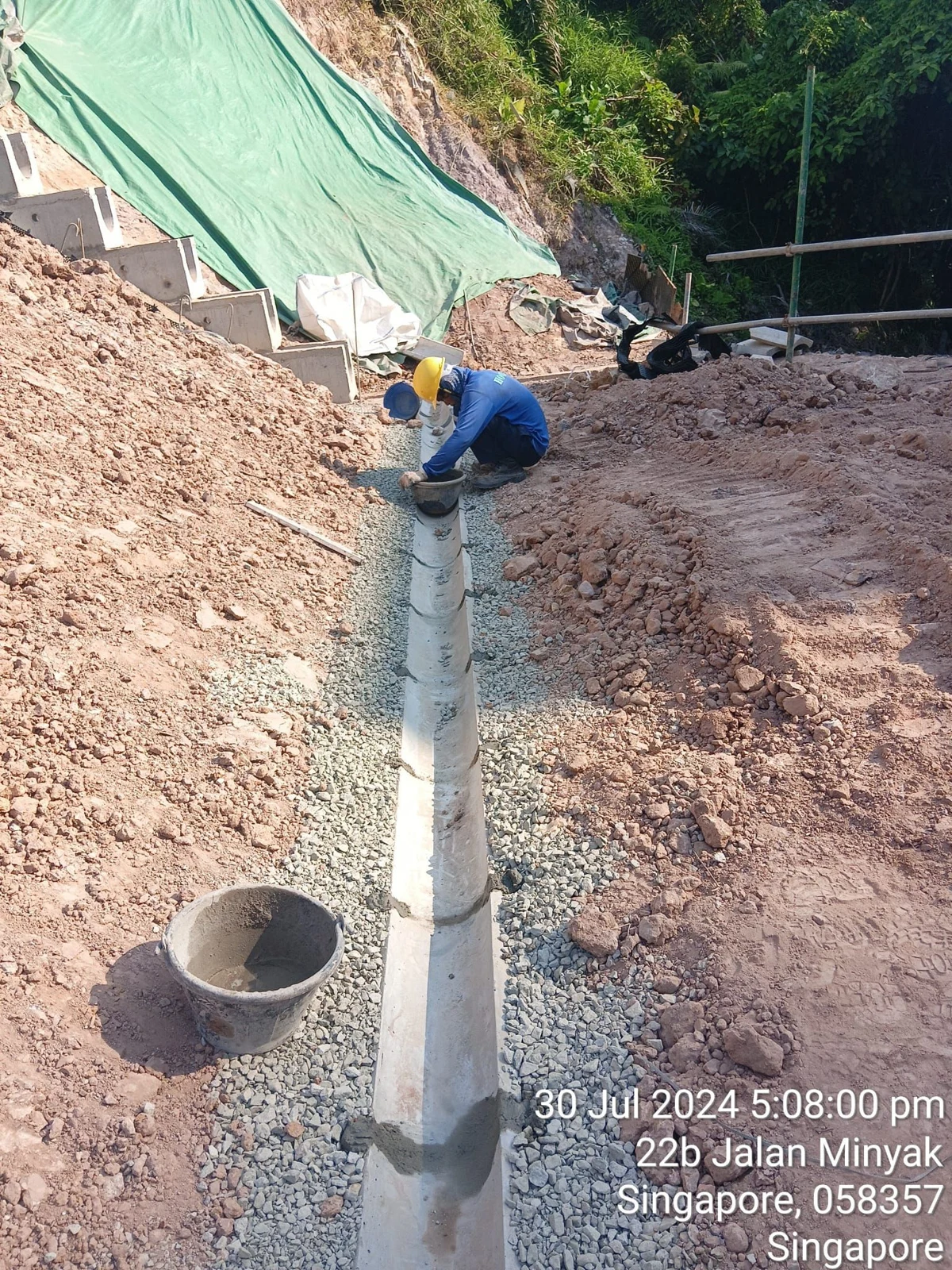

Figure 4: Constructing the surface runoff drains at the toe of the terrace.

Figure 5: Terrace platforms used for materials and machinery access

Site accessibility

The original access route was a narrow fire engine access path behind the hotel. Deliveries had to be made in batches while limiting disruption to hotel operations and guests. To improve access, Hocklim established a second route at the slope crest on Jalan Minyak.

Materials could then be delivered from the crest to the working platforms on each terrace. The construction sequence turned completed terraces into practical storage and access areas for the next stage of work.

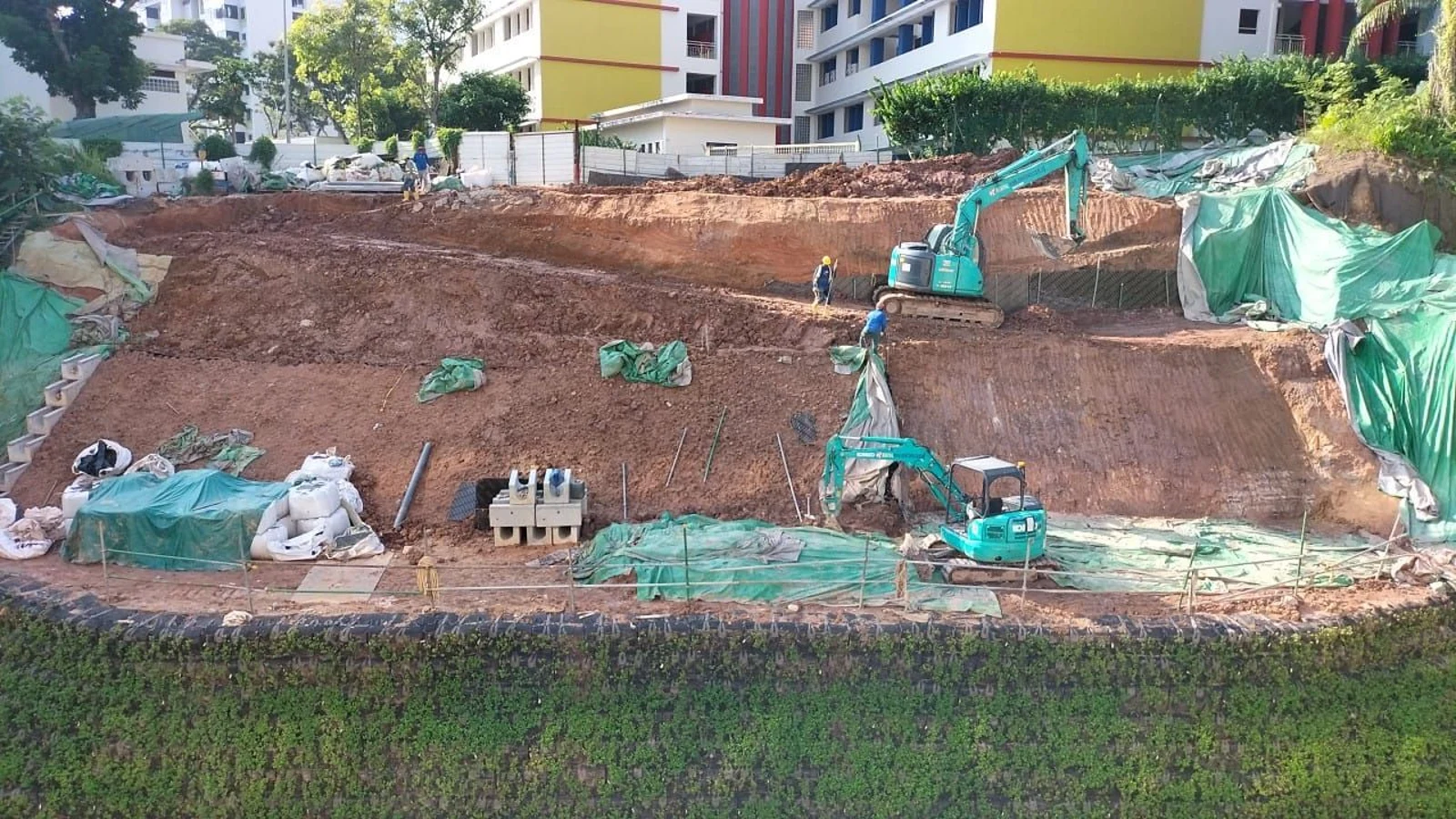

Figure 6: Excavators delivering materials from the crest of the slope to the respective working platforms

The completed system improves removal of surface and subsurface water while following the surrounding slope contours. The project demonstrates how drainage, slope stabilisation and site logistics can be addressed together.

Figure 7: Construction time lapse

LET’S BUILD WHAT’S NEXT

Let’s get your
project moving.

Discuss your project

HOCKLIM ENGINEERING PTE LTD

admin@hocklim.com+65 6564 5715
2025 Bukit Batok Street 23
#01-280, Singapore 659530

View original file
